|

          | If you do
            NOT see the Table of Contents frame to the left of this page, then Click here to open 'USArmyGermany'
            frameset
 |
          |
              499th
                Engineer Battalion555th Engineer Group
 Looking for more information from military/civilian
                personnel assigned to or associated with the U.S. Army
                in Germany from 1945 to 1989. If you have any
                stories or thoughts on the subject, please contact me
  . |
          |
 |
          |  |
          |
 |
          |  |
          | 1402nd
            Engineer Bn History |
          |  |
          | 195.
            - 1955 |
          | The 1402nd Engr
            Bn (Cbt) was a California National Guard unit. It was released from
            for active federal service on 17 January 1955 and replaced by a Regular
            Army unit, the 499th Engineer Battalion (Cbt), which was activated
            on the same date with all changes made less personnel and equipment. |
          |
 |
          |  |
          | 1955 |
          | (Source: THE
            MILITARY ENGINEER, Sep-Oct 1955) |
          | Bridging
              the Rhine
 By 1st Lt. Richard A. Finke

 In conjunction with a 280mm cannon crossing and field forces tests,
              three Class 60 floating bridges were constructed in 1954 across
              the Rhine River in the vicinity of Speyer, Germany, by the 1402d
              Engineer Battalion (Combat). The length of each bridge
              was approximately 780 feet.

 Construction was from the west to the east bank. Assembly time was
              measured from the start of raft assembly to the passage of the first
              vehicle. The assembly times were, respectively: 6 hours and 50 minutes,
              4 hours and 30 minutes, and 4 hours and 10 minutes. The time element
              was important because of the heavy commercial traffic on the Rhine
              River. Therefore, each bridge was assembled on a Sunday morning
              and taken out of the river that same afternoon. Approximately 600
              men participated in each exercise. The battalion had other mission
              commitments at the time and had to recruit an additional 100 men
              from separate companies under the 555th Engineer Group (Combat)
              to supplement the building crews.
 |
          |

                |  |  |

                      | The assembly of the bridge started with the construction
                        of four-float rafts at sites on a backwater downstream.
                        Six sites were used for each bridge operation. At two
                        of the sites the far-shore and near-shore reinforced end
                        sections were assembled while at the other four sites
                        four-float rafts were assembled. Deadmen for the high-line
                        towers, high-line cable, 45-degree cables to the bridge,
                        and bridge end sections were placed the night before.
                        The building began at dawn and started with the rolling
                        of the deflated pneumatic floats off the bridge trucks.
                        Six cranes, six air compressors, and ten powerboats were
                        used for the operation.
 While rafts were being assembled, another crew was assembling
                        a high-line tower upstream. The highline cable was then
                        ferried across the river and attached to a deadman on
                        the east bank. It was pulled out of the water on the west
                        bank by a D7 bulldozer.
 |  |  |
          | The assembled
            nearshore end section of the bridge was floated out of the backwater
            and pushed upstream of the site by powerboats. While upstream of the
            bridge site a raft delivery crew dropped the anchors from each float.
            The end section raft was then backed down from the anchor settings
            and swung into the prepared abutment site with the aid of the powerboats
            which then shuttled back and forth, bringing out the completed four-float
            rafts. They were anchored upstream of the bridge site by the same
            method employed with the end section raft.
 Powerboats floated the far-shore end section into place while the
            bridge was being assembled from the near-shore. A D7 bulldozer was
            ferried across on the far-shore end section and driven off onto the
            prepared abutment. The bulldozer blade was attached to the end section
            and used to move the section in and out so that the assembly crew
            could pin the last raft in place.

 While the rafts were being assembled to the bridge, another crew was
            placing 45-degree guyline cables upstream and downstream of the bridge
            and attaching rope lines from the upstream floats to the high line.
            Downstream anchors were also placed from every third float. These
            anchorages kept the bridge in alignment so that the last connecting
            raft could be easily put in place.

 Many problems were encountered. Bad roads at the raft assembly sites
            had to be constantly maintained. Communications, supply, and maintenance
            problems had to be dealt with. The training and break-down of crews
            for the raft assembly sites, end section sites, bridge site, deadman
            construction, abutment construction, highline tower assembly, and
            raft delivery were finished the week before the operation.

 The highlight of each bridge-building exercise was the crossing of
            the 280mm cannons (Figure above). The Class R^ Pride proved that it
            could pass the heavy load with ease.
 |
          |
 |
          |  |
          | (Source: Email from John "Jack" Clarke, Co "B," 1402nd Engr Bn (C)) |
          |  I was searching the Web yesterday and I saw the article about the 499th Engr Bn. It brought a lot memories for me. I was at Phillips Barracks in Karlsruhe from December 1952 till April 1954. I was in Company B of the 1402nd Engr Bn (Cbt) as Platoon Leader of the First Platoon. This was the bridge platoon for the floating bridge at Germersheim. I was bridge officer for the entire year of 1953 (I was the only 2nd Lt. the battalion) and I was in charge of a number of  "swings". I have a number of photographs of the bridge.
 Twice I failed to "swing" the bridge; once when the Rhine flooded and one we couldn't get the "mules" to start because of the  cold weather.

 I remember having a "duck" sink during one bridge swing. My platoon built the the first barracks on the west side of the  river on pilings.

 For years I have wondered about whether I knew any of those who died in the crash of the two C-119s. The article about the air disaster told me I did not.

 Thanks for bringing back some interesting members.
 |
          |
 |
          |  |
          | (Source: Email from Rodney Gant) |
          | I was drafted into the Army on June 19, 1953 during the Korean conflict. Fortunately, the conflict ended before I got out of basic training (AAA at Ft. Bliss in El Paso, TX). Consequently, most of the guys in my unit went to various assignments in Europe. I went to Germany.
 I was stationed in Karlsruhe, Germany, at Phillip’s Barracks from February 1954 to April 1955. I was in the 1402 Combat Engineer Battalion which was a part of the 555 (Triple Nickel) Engr Gp. On January 17, 1955 the 1402 colors were returned to California and the unit was replaced by the 499 Combat Engineer Battalion, which continued as a part of the 555 group.

 Each Company in my Battalion (except headquarters company) had its own permanent floating Bailey bridge on the Rhine River, and each month, one platoon from each Company would go to their respective bridge to maintain it for a month. My company had the one at Brühl. On the first Sunday of most months, all of the traffic on the Rhine River was stopped so that we could practice “closing” and “opening” the permanent bridge, while at other times, we would practice building a rubber pontoon bridge across the Rhine. On one occasion, we beat the record for bridging the Rhine. It was slightly less than 5 hours, and was a 52 pontoon, 60 ton, class m-4.

 On the occasion in which we broke the all time record, before we disassembled the bridge, our Group Commander had a helicopter  land where we had assembled into a large circle. Over a p.a. system he announced “Men, I am pleased, but not satisfied”. We were back out there building it again on other occasions, but we were so disappointed and discouraged at his statement, that we never again even tried to beat our own record.

 On one occasion we built the same type bridge but put twice as many rubber pontoons under it in order to see if it would support the 280mm atomic cannon. That was the first time that the 280 had crossed a floating bridge. The floats looked like they were about to submerge, and I’m sure the 280 drivers---two prime mover drivers, 1 pulling and 1 pushing--- didn’t feel too good about it either.

 We also upgraded our Bailey “swinging bridge” at Bruehl to a “Double Bailey”, in order to accommodate the 280.

 I drove a 2½-ton “deuce and a half” dump truck, and pulled a small trailer of explosives when we were on maneuvers. When we had an “alert”, several vehicles from our unit would go to the west side of the main highway bridge at Mannheim and wait along the banks until the alert was over. Our objective (if needed), was to blow out one section of the bridge. They always stressed the importance of not blowing up the abutments on either end because it would require so much work and time to replace them, as opposed to replacing/repairing one of the sections.

 Each year, our Company would have a joint training exercise with the Air Force, and several C119 Flying Boxcars flying in formation would take our Company up for a training flight. I participated in the mission in 1954. I rotated back to the States in April 1955, and 4 months later, on August 11, 1955, after taking off from Echterdingen Field, about 20 miles west of Stuttgart, one of the C119s had engine problems, causing it to collide with another one and they both crashed in the Black Forest. There were 55 or 56 (depending on the source of information), in my company that were killed. All were from the 499 Battalion, 555 Group, and (10 or 11) were killed from the 10th Troop Carrier Squadron, 60th Troop Carrier Wing at Rhein-Main Airbase. At that time, that was the fourth worst military air disaster in history. One soldier in my squad wrote and told me that the only reason he wasn’t on one of the planes was that he had been injured while practicing “high jumping”, in preparation for competition between Army units.

 On several occasions I had tried to find information on the internet regarding my old units, but the information was somewhat skimpy. But this past Saturday I went to see the Saint Patrick’s Day parade on Greenville Ave. in Dallas. I like to get to parade staging-areas early to see the various floats and equipment and mainly to talk with the people who will be in the parade. One man owned a DUWK, painted in traditional O.D. color with Army insignias. We talked about it as we related our common interest in the vehicle. I told him that I had worked many hours on and around DUWKs while building and maintaining bridges on the Rhine River. Until I told him, he was unaware that they were also designed to carry a Jeep. When I got home I begin looking for them on the internet, and accidentally pulled up DUWKs being used by my old unit. What a pleasant surprise that was! Thank you for the time and effort you have spent creating this web page.
 |
          |  |
          |
 |
          |  |
          | 499th
            Engineer Bn History |
          |  |
          | 1955
            - 1957 |
          |  499th Engineer Bn (Cbt) DUI |
          |  |
          | If you have more
            information on the history or organization of the 499th Engr Bn, please
            contact me  . |
          |
 |
          |  |
          | (Source:
              Email from Earl
              W. Watson, C Co, 499th Engr Bn (C)) |
          |


                |  |  |

                      | I was stationed with Charlie Company, 499th Engr. Bn. (C) from March 1955 to February 1957. Our mission at the time was to maintain three floating bridges at different locations on the Rhein River and to provide engineering support throughout Germany. We were stationed at Phillips Bks., Karlsruhe, Germany. Our parent organization was the 555th Engr. Gp. (C), also based at Phillips Bks.

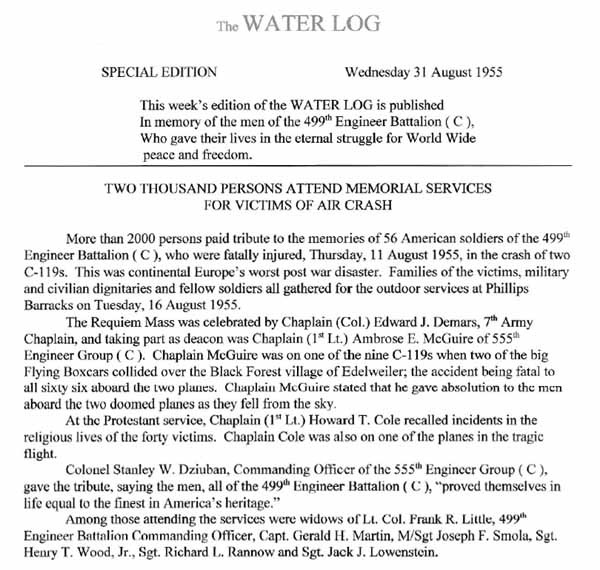

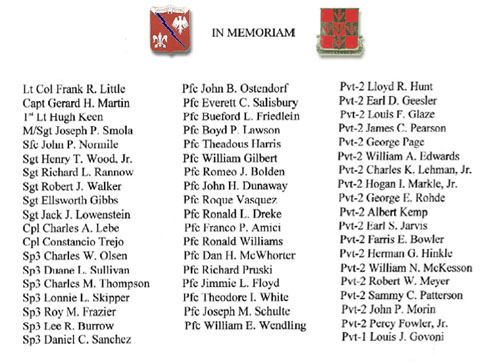

 On 11 Aug 1955, two C-119 Flying Boxcars with 56 men from the 499th, collided in midair over the Black Forest near the village of Edelweiler, Ger. All personnel on both planes were killed. There was a total of 56 men from the 499th Engr. Bn. (C) and 10 Air Force crewmen on both planes.

 In February 1957, the 499th Engr. Bn. (C) relocated to Ft. Benning, GA and was replaced in Germany by the 78th Engr. Bn. (C) under "Operation Gyroscope". The 499th was deactivated at Ft. Benning, GA in 1958.

 I do not know the complete history of the 499th Engr. Bn. (C) but I believe they received nine battle streamers during World War II. Was deactivated sometime after the war and was reactivated and sent to Germany in the early 1950s. I have an old copy of a weekly paper ("The Water Log"), that was published by the 499th. It is a special edition published on 31 Aug 1955 in memory of the 56 comrades who lost their lives in the tragic accident of 11 Aug 1955. This paper lists the names of all 56 men.
 |  |  |
          |               I was reading the history of the 555th Engr. Gp. (C) and on the
              same page there was an article about the 1402nd Engr. Bn. (C) in
              1954. I'm not familiar with the 1402nd but it seems to me that the
              499th was redesignated from another designation prior to my arrival
              in Germany. Could the 1402nd be the prior designation of the 499th?
              The reason that this is confusing to me is that when I got there
              we had three floating bridges on the Rhein River. These three bridges
              were semi-permenant with approximately 3/4 on one side of the Rhein
              and the other 1/4 on the other side of the Rhein (See attached photo).
              These sections of bridge were mounted on fully enclosed metal pontoons
              and when not in use, were stowed parallel with each bank of the
              Rhein. This allowed civilian shipping up and down the river. One
              of the bridges was constantly maintained by a platoon from C Co.
              499th Engr. Bn. (C).
 Every other Sunday each side was swung and pinned in the middle
              allowing access across the river. One of our bridges was near Speyer.
              These were class 60 floating bridges and could handle the load of
              the 280mm Atomic Cannon and the cannon's movers. The time frame
              between when the 1402nd Engr. built the floating bridges on rubber,
              inflatable pontoons and when I arrived in the 499th Engr. Bn. makes
              this a little confusing to me. However, I have no reason to doubt
              the validity of the role that the 1402nd played.
 |
          |  |
          |  |
          |  |
          |  |
          |

              |


                      | 499th Engr Bn Bridge site
 |  |
 |  |
 |
              |  1.   Class 60 float bridge (KB)

 |  2.  Barge passes bridge site (KB)

 |

 |
 |  |
          |  |
          |
 |
          |  |
          |  |
          |  |
          |  |  |
